Laverton North Data Centre Screening (demo)
Power and cluster read well: HV transmission adjoins the site (66 kV); Altona Terminal Station at 220 kV about 2,480 m; 10 data centre(s) within 8 km. The planning pathway is open: zoned IN2Z, no fatal flaws across the 19 of 19 constraints screened, with 4 Moderate issues to manage through the development application.
Instructions & Purpose
Desktop site decision memo for a candidate data-centre site prior to formal feasibility: grid power at the fence, whether the site joins an existing data-centre cluster, and whether the planning pathway is open.
Answer what a data-centre site decision turns on: is power close, would it join a cluster, and can it get planning consent. OpenStreetMap and drawn-boundary facts only; firm grid capacity, fibre routes and water for cooling are separate studies, not held here.

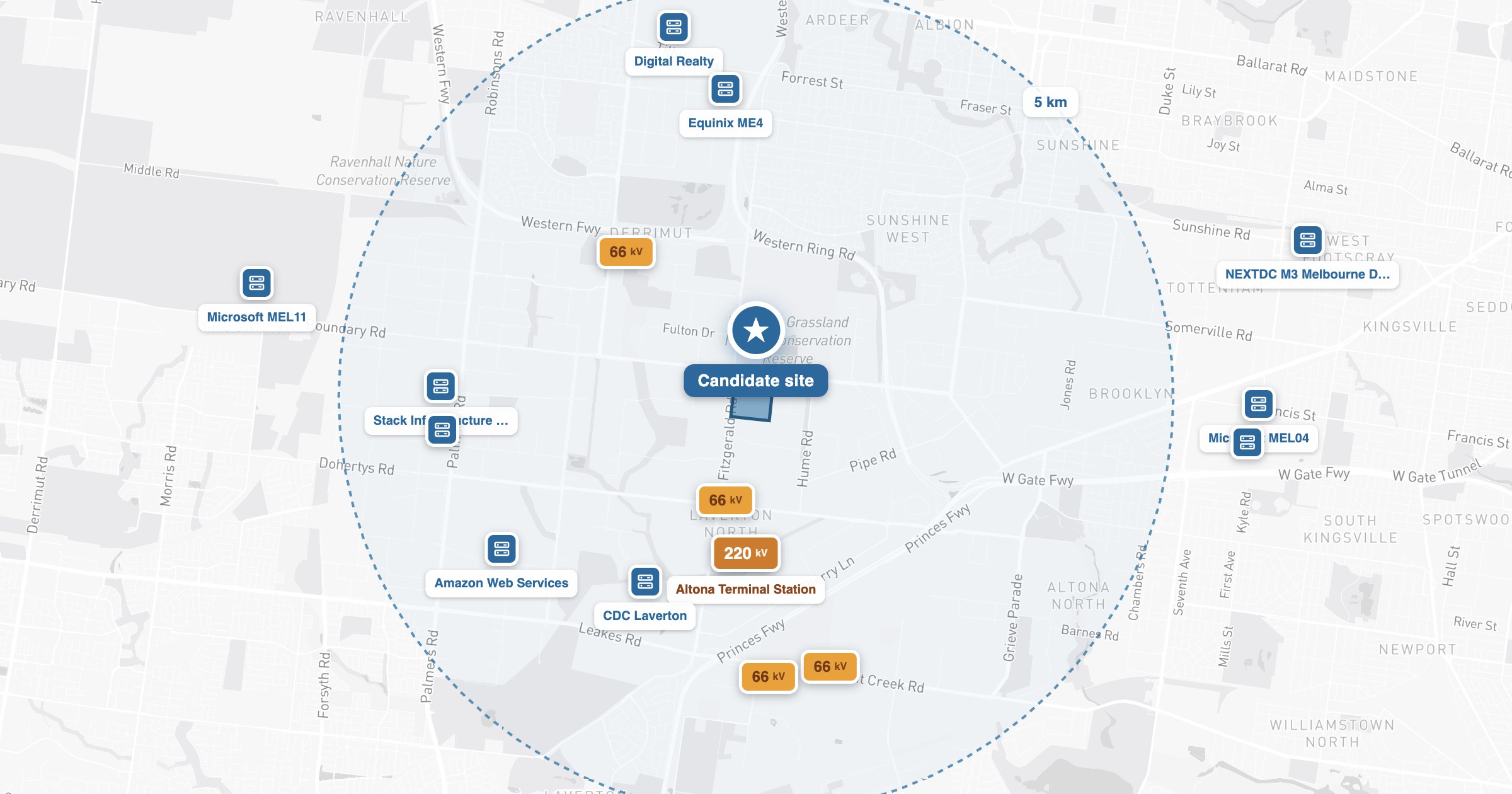

Power at the Fence, and the Cluster Around It
How much grid power is at the fence and whether the site joins an existing data-centre cluster, from OpenStreetMap and the drawn boundary. Raw facts to size the opportunity; this is not a demand model.
Grid power
The first question for a data centre: how much power is at the fence, and the substations that would feed it.
| Substation | Voltage | Distance |
|---|---|---|
| Laverton North Zone Substation | 66 kV | 1,283 m |
| OneSteel Customer Substation | 66 kV | 1,874 m |
| AirTrunk Data Substation | 66 kV | 2,329 m |
| Altona Terminal Station | 220 kV | 2,480 m |
| Altona Chemical Zone Substation | 66 kV | 3,352 m |
| Air Liquide Customer Substation | 66 kV | 3,356 m |
Source: OpenStreetMap (Overpass) substations + drawn-boundary HV proximity, at build time. Presence, distance and nominal voltage only; firm connection capacity and augmentation cost are a network study.
Existing data-centre cluster
13 data centres mapped within 8 km — joining an established cluster brings the fibre, power and peering ecosystem with it.
| Data centre | Operator | Distance |
|---|---|---|
| CDC Laverton | CDC | 3,091 m |
| Equinix ME4 | Equinix | 3,127 m |
| Stack Infrastructure MEL01A | Stack Infrastructure | 3,777 m |
| Stack Infrastructure MEL01B | Stack Infrastructure | 3,798 m |
| Amazon Web Services | Amazon Web Services | 3,882 m |
| Digital Realty | Digital Realty | 3,965 m |
| Microsoft MEL05 | Microsoft | 5,912 m |
| Microsoft MEL11 | Microsoft | 6,019 m |
Source: OpenStreetMap (Overpass), queried at report build time. Names are OSM labels quoted as-is; fibre routes and firm capacity are separate enquiries.
Industrial pipeline context: Wyndham
| Industrial / commercial DAs, LGA, last 12 months | 9 |
| Of which warehouse / logistics-described | 3 |
| Industrial / commercial DAs, state-wide, last 12 months | 1,533 (180 warehouse / logistics-described) |
| Residents of Laverton North | 119 — an industrial precinct is meant to be empty of residents, and this one largely is |
Our tracking of Wyndham is currently partial, so the LGA count understates real activity; the state-wide figures are the reliable context.
Source: DA Leads tracked application records (da_records) + ABS SAL profile.
Power is the first question, and it reads well here: HV transmission crosses or adjoins the site (66 kV); the highest-voltage station nearby is Altona Terminal Station at 220 kV, about 2,480 m. The site would join an established cluster: 10 data centre(s) mapped within 8 km, including CDC Laverton, Equinix ME4, Stack Infrastructure MEL01A, with the fibre, power and peering ecosystem that brings. Firm grid capacity, fibre routes and water for cooling are separate enquiries, not desktop facts.
HV proximity and substation facts are OpenStreetMap and the drawn boundary; firm connection capacity and augmentation cost are a network connection study, not held. Fibre backbone routes and carrier availability are not in our data and are not shown. Water for cooling is a utility enquiry; we do not model it. Existing data centres are OSM labels at last refresh; a market or capacity census is not made.
The Site, Zoning & the Contested Issues
The candidate site itself, then the statutory screen: 19 constraints on the four-level scale. The zone question and the issues this kind of development is typically assessed on are set out in full below; the remaining constraints are condensed into the screening table, ordered most severe first, with their full risk detail retained in the screening dataset.
The candidate site
Statutory controls over the site
| Zone | IN2Z - INDUSTRIAL 2 ZONE |
|---|
No planning overlays detected over the site from available data.
The site is zoned IN2Z - INDUSTRIAL 2 ZONE. Zoning establishes whether the proposed generation use is envisaged, assessable with consent, or prohibited, and sets the assessment pathway.
Legislation: State planning legislation and the applicable planning scheme / Planning and Design Code
| Aspect | Risk | Mitigation | Rating |
|---|---|---|---|
| Applicable zone | Site zoned IN2Z - INDUSTRIAL 2 ZONE |
|
Insignificant |
- Confirm zone provisions and the assessment pathway with the planning authority
Noise impact was screened by distance to the nearest sensitive receptor (the closer of the nearest GNAF dwelling address point and the nearest residential zone). Combustion turbines and rotating plant emit mechanical noise; separation distance and attenuation determine compliance with the state noise policy.
Legislation: Environment Protection Regulations 2021 (Vic) noise provisions
| Aspect | Risk | Mitigation | Rating |
|---|---|---|---|
| Noise at sensitive receptors | the nearest dwelling (20 OXFORD ROAD LAVERTON NORTH VIC 3026) about 221m away |
|
Moderate |
- Environmental noise assessment / modelling against the state noise policy
- Select low-noise equipment and acoustic treatments as required
Traffic was screened on project type rather than site-specific counts. Utility-scale energy projects generate concentrated heavy-vehicle traffic during construction and deliver major components as OSOM loads. A Traffic Impact Assessment and OSOM route assessment are required at the development application stage; operational traffic for a generation / storage site is low.
Legislation: State road / planning authority traffic impact and OSOM permit requirements
| Aspect | Risk | Mitigation | Rating |
|---|---|---|---|
| Construction traffic | Heavy-vehicle movements on the local road network during construction |
|
Minor |
| OSOM deliveries | Over-size / over-mass plant deliveries require route assessment and permits |
|
Minor |
| Operational traffic | Low ongoing traffic (staff / maintenance) |
|
Insignificant |
- Traffic Impact Assessment (TIA) covering construction and operation
- OSOM route assessment and permits for major plant deliveries
- Construction Traffic Management Plan agreed with the road authority
The principal on-site hazard is bulk diesel storage for standby generation, a dangerous good under AS 1940 storage and handling requirements. Quantities are typically below Major Hazard Facility thresholds but must be confirmed; any UPS battery rooms are subject to their own fire-safety standards.
Legislation: Dangerous goods (storage and handling) legislation (state); AS 1940:2017 (the storage and handling of flammable and combustible liquids)
| Aspect | Risk | Mitigation | Rating |
|---|---|---|---|
| Bulk diesel storage / standby generation | the nearest dwelling (20 OXFORD ROAD LAVERTON NORTH VIC 3026) about 221m away; diesel quantities must be confirmed against dangerous-goods manifest and notification thresholds |
|
Minor |
- Confirm diesel storage quantities against dangerous-goods manifest and notification thresholds
- Fuel storage design to AS 1940 (bunding, separation, fire protection)
- Fire safety study covering generator halls, fuel storage and any UPS battery rooms
The rest of the screen
| # | Constraint | Rating | Key finding | First check before reliance |
|---|---|---|---|---|
| 5 | Cadastral / Title & Easements | Moderate | 1 infrastructure corridor(s) / easement(s) cross the site; these carry registered easements and setbacks that constrain where plant can be built. | Order a Certificate of Title and plan of subdivision from the state land registry |
| 6 | Flora & Fauna / Ecology | Moderate | Threatened biota, native vegetation or a nearby reserve identified. | Flora and fauna survey by a qualified ecologist |
| 7 | EPBC / Matters of National Significance | Moderate | A Matter of National Environmental Significance is likely triggered; EPBC referral required. | Generate a Protected Matters Search Tool (PMST) report for the site |
| 8 | Aboriginal Heritage | Minor | Outside a mapped Area of Cultural Heritage Sensitivity; protection still applies (a sensitivity model, not a site register). | Unexpected finds procedure during ground-disturbing works |
| 9 | Visual Amenity | Minor | Terrain visibility moderate; Site at 32.0m has mixed surrounding terrain (7 points lower, 9 higher, 8 similar). Partial | Visual impact assessment with photomontages from key viewpoints |
| 10 | Geotechnical Survey required |
Minor | Not desktop-assessable; intrusive geotechnical investigation required. | Commission a geotechnical investigation (boreholes / test pits) at detailed design |
| 11 | Air Quality | Minor | Data centre: no continuous combustion, but standby diesel generators produce intermittent testing emissions; EPA licensing depends on the installed generator capacity. | Confirm EPA licensing thresholds for the aggregate standby generator capacity |
| 12 | Planning Overlays | Insignificant | No planning overlays intersect the site. | Confirm with the current planning scheme that no overlays apply |
| 13 | Historic / Federal Heritage | Insignificant | No listed historic heritage place within 1km. | Confirm against the Australian Heritage Database and the state heritage register |
| 14 | Bushfire | Insignificant | Site is not within a mapped bushfire prone area. | Confirm the classification with the fire authority before detailed design |
| 15 | Hydrology / Flooding | Insignificant | No mapped flood hazard or overlay affects the site. | Confirm the relevant flood level (e.g. 1% AEP) with the floodplain authority |
| 16 | Contours / Topography | Insignificant | Mean site slope about 0.6% from the SRTM 30m elevation model. | Confirm levels and gradients with a feature and level survey |
| 17 | Soils | Insignificant | No acid sulfate or reactive soils mapped over the site. | Confirm soil conditions in the geotechnical investigation |
| 18 | Utilities (power / gas / water / NBN) | Insignificant | Transmission line within 1m (66kV); Gas transmission pipeline within 370m; Water / sewer main within 23m | Network connection study with the transmission operator |
| 19 | Contaminated Land | Insignificant | No EPA-listed contaminated site within 500m. | Phase 1 environmental site assessment if prior industrial use is suspected |
Ratings use the four-level scale in Appendix A. Constraints marked Survey required have NOT been assessed as low risk; the phased action plan sequences their checks.
The Consent Pathway, and What Has Been Approved
The approvals a project of this type would typically require, and recent comparable projects approved on a similar pathway.
| Approval | Authority | Trigger |
|---|---|---|
| State planning consent | Responsible authority / Minister for Planning | Applicable state planning legislation |
| EPBC referral (if MNES significantly impacted) | DCCEEW (Commonwealth) | Potential significant impact on a Matter of National Environmental Significance |
| Native vegetation clearance | State native vegetation authority | Clearance of native vegetation |
| Network connection (major load) | Distribution / transmission network operator | Connection application and agreement for a new high-voltage load |
Comparable approved projects
Precedents de-risk the approval thesis; they are indicative only and each application turns on its own merits.
| Project | Scale | Approval pathway | Year |
|---|---|---|---|
| West Footscray data centre, 63 Sunshine Road (PA2403320) Melbourne data centre approved on the DFP ministerial pathway. | Data centre with associated car parking, access and landscaping | Ministerial planning permit via the Development Facilitation Program (significant economic development class); decided 4 April 2025. | 2025 source |
| NEXTDC S4 Data Centre, Horsley Park (SSD-63741210) Recent approved Western Sydney hyperscale campus on the SSD pathway. | Six data centre buildings, ~250 MW operational capacity | State Significant Development under the NSW EP&A Act 1979 (data centres above the SEPP power-consumption threshold are SSD); approved 24 December 2025. | 2025 source |
Recommended Action Plan
The phased sequence from this memo to a lodged development application.
| Phase | Actions |
|---|---|
| Immediate (week 1 to 2) |
|
| Pre-DA specialist work (week 3 to 12) |
|
| Detailed design |
|
No fatal flaws identified
Power and cluster read well: HV transmission adjoins the site (66 kV); Altona Terminal Station at 220 kV about 2,480 m; 10 data centre(s) within 8 km. The planning pathway is open: zoned IN2Z, no fatal flaws across the 19 of 19 constraints screened, with 4 Moderate issues to manage through the development application.
What this site has going for it
- Power is at the fence: HV transmission crosses or adjoins the site (66 kV); the highest-voltage station nearby is Altona Terminal Station at 220 kV, ~2,480 m
- Joins an established cluster: 10 data centre(s) mapped within 8 km, including CDC Laverton, Equinix ME4, Stack Infrastructure MEL01A, with the fibre, power and peering ecosystem that brings
- The planning pathway is open: zoned IN2Z, no fatal flaws across the 19 of 19 constraints screened, with 4 Moderate issues to manage through the DA
What to watch
- Firm grid capacity is the real gate, and mapped HV proximity is not it: a network connection study decides how many MW can actually be delivered and at what cost
- Fibre backbone routes and water for cooling are separate carrier and utility enquiries, not desktop facts
Every line above stands on a number earlier in this memo; none of it replaces the specialist assessments in the action plan.
Planning screen detail: No Major red flags across the 19 assessable constraint(s). 4 Moderate constraint(s) require mitigation through the development application.
Indicative screening fee: A$1000 per site.
Method, Data & Rating Scale
This is a desktop red flags screen. The drawn site boundary was intersected against national and state planning, hazard and environmental spatial layers, supplemented by state planning services and an SRTM elevation model. Each constraint is rated on the four-level scale, and where data is unavailable for the state it is flagged for survey rather than assumed clear.
How this screen was produced
- Spatial intersection of the site polygon against the mapped constraint layers
- State planning service queries for zoning, overlays and the nearest residential receptor
- Terrain analysis (slope and visibility) from a 30m elevation model
- Rule-based rating per constraint, with a data status recorded separately from the rating
Limitations
- Mapped vector data is generalised at zoom and is not survey accurate; boundaries and distances are indicative.
- Data coverage varies by state. Constraints flagged data-limited require a specialist survey and are NOT low-risk.
- EPBC matters are screened by proximity and mapped layers only; a Protected Matters Search Tool report and self-assessment are still required.
- This screen does not replace a title search, specialist assessments, modelling, or the formal development application.
Risk rating scale
Each constraint is rated on a four-level scale. Constraints that could not be assessed from available data are shown separately and are not treated as low risk.
Significant; likely to preclude development unless rectified (potential fatal flaw).
Significant; will need to be mitigated.
Evident but not significant; readily mitigated.
No constraint on development proceeding.
Could not be assessed from available data; further investigation required. This is NOT a low-risk finding.
Indicative Scope of Work & Fees
Indicative scope and fees to take this site from screening to a lodged development application. The site screen is a fixed fee; later phases are scoped against the red flags identified above and are a small fraction of the cost of progressing an unscreened site to formal feasibility.
| Task | Detail |
|---|---|
| Site screening (this report) | Desktop red flags across planning and environmental constraints to confirm no fatal flaw before feasibility spend. |
| Title and cadastral review | Certificate of Title, plan of subdivision, easements and ownership consolidation. |
| Pre-lodgement planning advice | Confirm the zone pathway and overlay requirements with the planning authority. |
| Specialist assessments (as triggered) | Flora and fauna, heritage, noise, air quality, bushfire, hydrology and geotechnical scopes set by the red flags above. |
| Development application preparation and lodgement | Compile and lodge the development application with the supporting specialist reports. |
| Item | Indicative fee (ex GST) |
|---|---|
| Red flags site screen (per site) | A$1,000 |
| Title and cadastral review | A$0.5K to A$1K |
| Pre-lodgement planning advice | A$3K to A$6K |
| Flora and fauna assessment | A$15K to A$30K |
| Heritage assessment / CHMP | A$10K to A$40K |
| Noise assessment | A$15K to A$25K |
| Geotechnical investigation | A$10K to A$25K |
| Development application preparation | A$30K to A$60K |
Fees are indicative ranges excluding GST and vary with site complexity and the assessments triggered.
